Private island design is a feasibility exercise before it is a styling one: the first task is to establish whether the land can support the home or small retreat you have in mind. Before buying a private island or beachfront property, test ownership, buildable land, shore access, freshwater, power, wastewater and construction logistics together. An attractive asking price says little about what it will cost to make the place usable.
Quick answer: what is private island design? Private island design is the coordinated planning of buildings, landscape, utilities, arrival and environmental protection for a site where each depends on the others. It decides where building is permitted and practical, what should stay untouched, how water, power and wastewater will work, and how people and materials will arrive. Before committing to a purchase, gather evidence on legal title and build rights, the surveyed buildable area, shoreline and marine access, protected habitat, utility feasibility, construction logistics and running costs, and weigh the findings together. This guide is general information. It does not replace legal advice, surveys, valuations, engineering or local approvals.
- What should you know before buying a private island?
- Five site checks for private island design
- Compare the usable site, not just the asking price
- Legal constraints that shape private island architecture
- Private island development costs and financial checks
- Environmental rules for private island design
- Private island due diligence before design
- Compare island sites by their constraints
- Operations, lifestyle, and long-term island value
- Before you commit: three checks
- Sources and design references
- Turn the findings into a purchase decision
- FAQ
- What is private island design?
- What should a private island design brief include?
- How much does it cost to develop a private island?
- What legal factors should I consider when buying a private island?
- How can I assess the potential financial return on an island investment?
- What environmental and sustainability practices should I implement on my island property?
- What are the key considerations for financing and conducting due diligence on an island purchase?

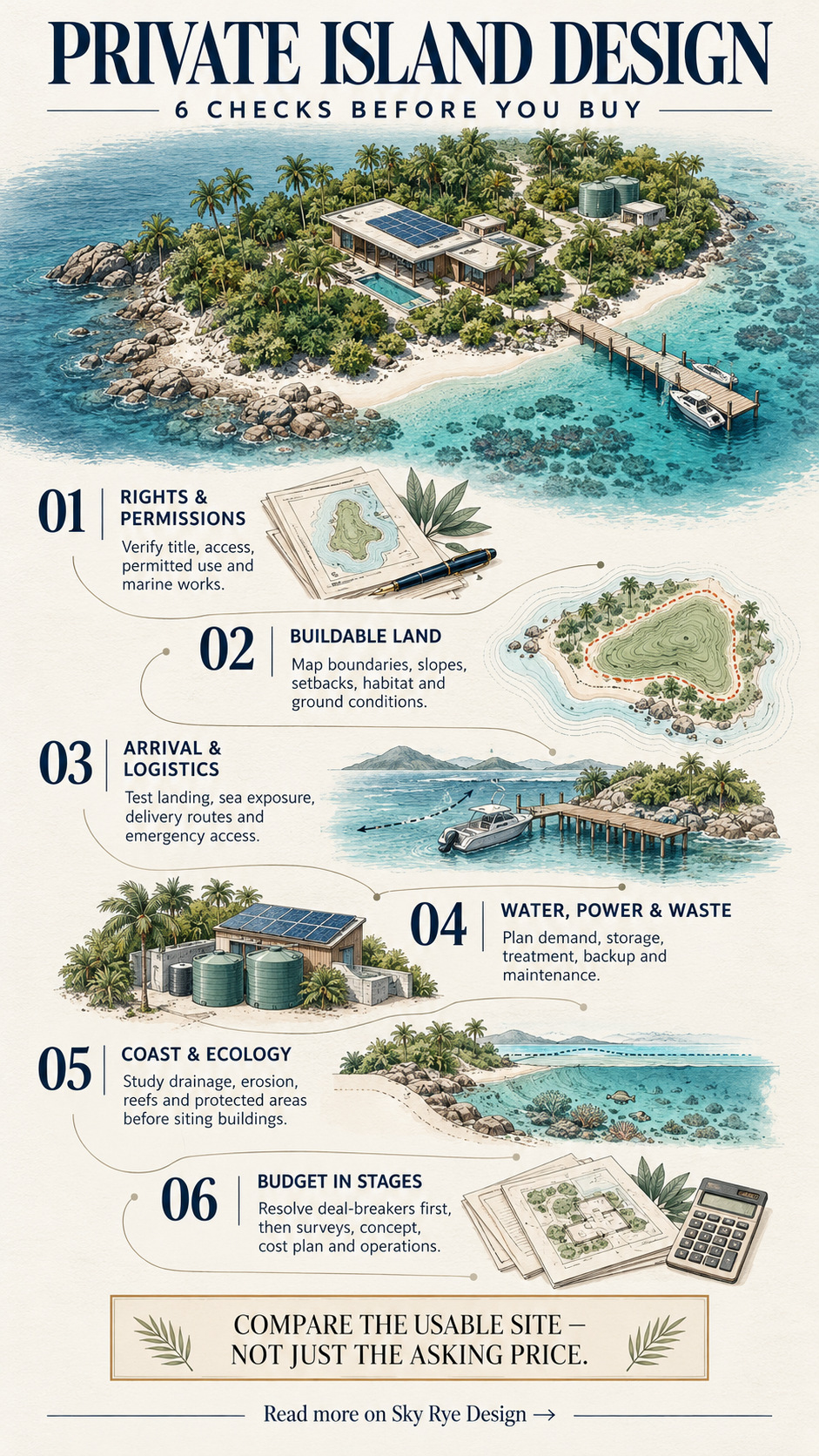

What should you know before buying a private island?
Commission legal and technical due diligence before committing to a purchase. Ask an independent local lawyer to check the ownership documents and permitted uses, and ask the design team to map the buildable land. Owning an island does not, by itself, establish a right to build a villa, operate a resort, or install a dock.

Start with an annotated site plan rather than a finished villa rendering. Mark the shoreline, contours, vegetation, existing buildings, proposed arrival point, and utility locations. The plan should show what is known, what is assumed, and which surveys or permissions are still missing.
A feasibility study connects these findings to a preliminary budget and programme. It should identify decisions that could change the purchase: an unusable landing point, uncertain access rights, protected habitat across the proposed building area, or a water system that needs more power than the initial design allows.
Use the study to decide whether to proceed, revise the scope, or investigate further. Attractive architecture cannot compensate for unresolved ownership, an unserviceable building, or a development plan that depends on permissions no one has checked.
| Due diligence area | What to verify | Why it affects design |
|---|---|---|
| Ownership and build rights | Freehold, leasehold, concession terms, local ownership limits | Determines what can be built, sold, financed, or transferred later. |
| Coastal setbacks | Buildable land, shoreline rules, protected zones, storm exposure | Controls villa placement, guest circulation, and whether the design can stay low-impact. |
| Reef and water quality | Coral health, drainage paths, no-anchor zones, sediment risk | Shapes dock placement, runoff control, deck orientation, and activity planning. |
| Utilities | Solar, batteries, desalination, greywater, solid waste, backup power | Decides roof geometry, service routes, plant rooms, and operating cost. |
| Arrival and logistics | Dock depth, boat approach, helicopter feasibility, barge access | Affects material choices, construction sequence, and the first guest impression. |
Five site checks for private island design

Before commissioning renderings, answer five site questions: where is construction permitted, where does stormwater go, how will utilities be maintained, how will people and materials arrive, and which areas should remain undisturbed? Record each answer on the same plan so conflicting uses become visible.
- Buildable land: compare surveyed boundaries, slope, ground conditions, setbacks, and protected areas. Advertised acreage is not the same as buildable acreage.
- Water movement: map drainage routes and identify where construction runoff could reach sensitive shoreline or marine habitat.
- Utilities: reserve space for equipment, safe clearances, service access, storage, and future replacement.
- Arrival: check water depth, seasonal exposure, landing permissions, and the route from boat to building.
- Conservation: mark areas to retain and agree how workers, vehicles, guests, and maintenance teams will avoid them.
The useful output is a decision map: a drawing that separates confirmed building areas from conditional proposals and areas that should remain untouched.
For example, a sheltered beach might look like the obvious arrival point but have shallow water or sensitive habitat. Moving the landing elsewhere could add a longer service path and change where materials can be unloaded. Resolve that relationship before placing guest villas around a fixed arrival sequence.


Keep different professionals responsible for their own evidence. A boundary survey, marine survey, legal title review, and architectural concept answer different questions. A sales brochure or a promising site visit cannot replace any of them.

The stages of architectural design services help structure that work, from an initial brief to coordinated drawings. Listings such as Kepri Estates — Islands & Beaches can help identify possible coastal properties; verify each listing’s ownership, access, and development claims independently before relying on them.
Compare the usable site, not just the asking price
Compare properties by the usable project they can support, not by the purchase price alone. A smaller site with documented access and functioning utilities may suit a modest retreat better than a larger undeveloped island with unresolved infrastructure. The appropriate comparison depends on your intended use and tolerance for ongoing maintenance.
Separate the land price from surveys, professional fees, permits, marine works, buildings, utilities, transport, and operating reserves. Published island cost guides offer broad market context, but a local contractor’s scope-specific estimate is needed for a purchase decision. Ask which exclusions and assumptions sit behind every estimate.

Define the operating brief before comparing listings:
- Personal retreat: set the number of occupants, length of stays, caretaker arrangements, storage needs, and acceptable interruptions to access or power.
- Hospitality use: identify the permissions and services needed for the proposed guest capacity. Include staff accommodation, deliveries, laundry, emergency access, and waste removal in the first space schedule.
- Resource demand: translate sustainable living goals into a water and energy budget. Specify what the project must provide during a dry spell, equipment outage, or period when deliveries cannot reach the island.


Legal constraints that shape private island architecture
The questions raised by Phuket island real estate need to be checked against the particular property and jurisdiction. Give an independent local lawyer the proposed use, buyer details, and draft transaction documents. Ask for a written account of the rights being acquired and the approvals still needed.
- Title, lease, or concession: establish the legal interest being offered, remaining term, charges, restrictions, transfer conditions, and any renewal wording. Do not assume a future extension or a lender’s acceptance. Confirm how ownership of existing buildings and improvements is treated.
- Beach and water access: establish the surveyed land boundary, foreshore or seabed rights, public access rights, and any easements. A property described as a private beach may still have public access or use rights. Ask which rights allow a landing, mooring, dock, or seawall.
- Development permission: request the current zoning and rules for buildings, setbacks, habitat protection, wastewater, and commercial use. Check which agencies must approve the proposal and whether existing approvals transfer to a buyer. Treat proposed changes of use as unresolved until confirmed.
These are separate checks. As a United States example, the USACE Honolulu District lists docks and shoreline stabilization among activities that may need a permit. California’s State Lands Commission separately explains public rights to waterways and the coast. Neither example determines the law for an island elsewhere; use the relevant local authorities and legal advice.
For those jurisdiction-specific examples, see USACE Honolulu permit guidance and California State Lands Commission public access guidance.
Private island development costs and financial checks


Build a project budget before modelling income. Good design can improve usability, but it does not guarantee appreciation, occupancy, resale demand, or a profitable resort. Keep the acquisition decision separate from optimistic assumptions about future rates or a sale price.
- Capital costs: price surveys, design, approvals, transport, foundations, buildings, landing facilities, power, potable water, and wastewater treatment as separate packages. Add an explicitly justified contingency for the unresolved items rather than applying a universal island construction multiplier.
- Operating costs: allow for staffing, insurance quotations, boat servicing, fuel, replacement equipment, communications, water testing, cleaning, and waste removal. Compare a low-use personal retreat with a staffed rental operation; they require different budgets.
- Design scope: the custom home design process discussion illustrates why the brief affects a custom project’s scope. Coordinate design and construction decisions with suppliers and transport contractors, and identify what must be completed before a building can be occupied.
- Financial checks: ask an appropriately qualified adviser to review financing, taxes, cash flow, and downside scenarios. Test delayed permissions, reduced occupancy, weather closures, higher operating costs, and a slower resale. Record evidence for each assumption.
Environmental rules for private island design
Map habitat and water systems before deciding where to clear vegetation or build. The EPA identifies coastal development, sediment, and pollution among threats to coral reefs. NOAA also explains how land-based runoff and wastewater can affect reef health. Use a qualified environmental team to turn those risks into a site-specific plan.

Designing around the reef, not over it
Ask the marine and environmental specialists to define construction controls for the actual work, current, seabed, and habitat. Sediment barriers may be appropriate in some conditions; they are not a universal solution or a substitute for avoiding sensitive areas and securing permissions.
On land, coordinate finished levels, paths, planting, storage areas, and drainage. Show where runoff will travel during construction as well as after completion. The landscape design process provides a useful way to connect site analysis with grading, circulation, and planting decisions.
Locate guest circulation and viewing areas without requiring people or boats to pass through sensitive habitat. Ask the team to specify how the site will be marked, how contractors will receive the plan, and who checks compliance during construction.
Agree the maintenance arrangements too: drainage inspections, wastewater servicing, spill response, and any required environmental monitoring. Protection measures need named responsibilities and an operating budget. A conservation area on a drawing is only useful if the day-to-day operation respects it.
Integrating solar into the landscape
Estimate electrical demand before choosing panel locations. Include water treatment, refrigeration, cooling, pumps, communications, and any workshop or hospitality equipment. Then compare roof-mounted panels, a service building, or another permitted location against shading, wind exposure, cable routes, maintenance, and visual impact.
There is no single roof angle suitable for every island. Solar orientation and tilt depend on latitude, the system, and project constraints. The EIA reference below describes historical United States utility-scale installations, not a specification for tropical villas. Have a qualified designer size the system and specify safe battery placement, ventilation, clearances, and fire provisions.
Set out the backup strategy and replacement route for heavy equipment before hiding services behind finishes. Include space for a technician to inspect connections and remove a failed component. Consider a small wind system only after assessing the local wind resource, permissions, noise, maintenance, and access for repairs.
Water and waste as design problems
Compare permitted freshwater options using expected demand, seasonal availability, quality testing, storage needs, and maintenance. If desalination is proposed, include energy use, intake arrangements, and brine discharge in the feasibility work. Wastewater and any greywater reuse need their own treatment design and regulatory review; landscaping alone is not treatment.
The planning of waterfront structures and access should be coordinated with these services. Keep plant rooms, waste storage, delivery routes, and maintenance clearances on the masterplan. Screening can improve the view, but it must not block ventilation, safe operation, or equipment replacement.

Private island due diligence before design
Ask prospective lenders about the specific property, legal interest, intended use, and borrower situation before assuming finance will be available. A mortgage or business loan on mainland property does not establish that equivalent terms will be offered for an island.
Request written information about valuation, security, insurance, required documents, drawdown conditions, fees, and currency exposure. If seller finance or an investor structure is proposed, have independent advisers review the obligations and default terms. Do not treat an informal indication as a financing commitment.
Commission investigations in stages. Start with matters that can rule out the project, such as title, access, permitted use, and environmental constraints. If those checks support proceeding, develop the technical surveys, concept options, cost plan, and operating assumptions needed for the next decision.
Have the legal team advise how the contract should address outstanding investigations and approvals. Keep a dated register of documents received, unresolved questions, responsible advisers, and decision deadlines.
Due diligence items with direct architectural implications:
- Survey and ground conditions: commission the appropriate boundary, topographic, and geotechnical work. Ask separate specialists to assess coastal hazards and water availability; a ground investigation does not predict a shoreline’s long-term position.
- Environmental baseline: identify protected habitat and species, previous development, existing discharges, and any investigation or remediation needed. Use the findings to compare buildable options.
- Transport and construction: obtain a logistics plan covering loading points, vessels, sea conditions, storage, lifting, temporary works, worker accommodation, and waste. Decide which components can realistically be delivered and installed.
- Feasibility record: request an annotated site plan, permissions schedule, preliminary cost plan, utility concept, and list of unresolved risks. Put the assumptions beside the drawings so the next designer or contractor can check them.
A site-visit checklist before buying a private island
Bring a base plan and use the visit to collect information your advisers can check. The aim is to connect the listing photographs with actual access, equipment and daily use, while keeping survey and permission questions open.
- Record the arrival conditions. Note the visit date, tide and weather, then photograph the landing and route inland. Ask an experienced local operator which conditions interrupt access; one calm crossing cannot establish year-round reliability.
- Walk the delivery route. Follow the proposed route from unloading point to building area. Photograph narrow turns, steep sections and places where equipment would need lifting. Give these records to the logistics team before selecting large prefabricated components.
- Locate existing service equipment. Mark tanks, pumps, power equipment and wastewater facilities on the site plan. Ask for capacity, approval and maintenance records. Photographs show what is present, but do not establish that a system works or meets requirements.
- Record drainage and site condition. Photograph erosion, standing water, exposed foundations and visible corrosion without disturbing habitat. Give each observation a location and date for the relevant surveyor or engineer to investigate.
- Test the everyday route. Walk between arrival, accommodation and proposed service areas. Note shade, steps, carrying distances and places where guest movement would cross deliveries or maintenance work.
- Keep a follow-up list. For each unanswered question, record the evidence needed, the adviser responsible and the decision it affects. Separate observations made during the visit from claims supplied by a seller.
Compare island sites by their constraints

Choose a site type before choosing a visual style. The following comparison is a planning aid, not a ranking of investment markets. Two nearby islands can have different access, exposure, habitat, and legal conditions.
| Site condition | Design question | Evidence to request |
|---|---|---|
| Sheltered tropical shoreline | Can arrivals and drainage avoid sensitive habitat? | Marine survey, habitat map, seasonal access assessment |
| Exposed coast | How will structures and materials handle wind, spray, and flooding? | Local hazard assessment, structural design basis, material specifications |
| Steep or rocky terrain | Can construction and maintenance reach the building areas? | Topographic and geotechnical surveys, route and lifting plan |
| Existing developed island | Which buildings and systems can be retained legally and practically? | Approval records, condition survey, utility capacity and service records |
Operations, lifestyle, and long-term island value
Design for maintenance and replacement
Plan for the years after handover. Specify components that can be inspected, maintained, and replaced with the equipment available on site. The guide to coastal house design and salt exposure is a useful starting point for discussing corrosion, drainage, and maintenance access with the project team.
For warm sites, compare tropical house layouts, shade, and ventilation before fixing room orientation and roof geometry. Adapt the ideas to local wind, rain, humidity, and security needs. A covered service route can matter as much to daily operation as a generous guest terrace.
Plan with local knowledge
Consult nearby communities and experienced local operators about seasonal access, supply routes, construction methods, and maintenance. Use architectural precedents as visual references while checking practical details with the team. Planning staff housing needs the same attention to comfort, privacy, utilities, and permitted occupation as guest accommodation.
Before you commit: three checks
- Verify rights before fixing the design: title, beach access, marine works, and building permission are separate questions.
- Budget for the whole property: include transport, utilities, staffing, maintenance, and replacement costs alongside buildings.
- Keep decisions evidence-based: distinguish confirmed facts, design assumptions, and unresolved permissions. Revise the concept when the surveys require it.
Sources and design references
Use these references for the topics identified below. Environmental guidance describes risks, while legal requirements and engineering details must be checked for the actual site. The commercial cost guide provides market context rather than a project quotation.
- EPA: threats to coral reefs
- NOAA: land-based pollution and coral reefs
- U.S. EIA: solar panel tilt and latitude
- Private Island Market: island cost and development guide
Turn the findings into a purchase decision


Before buying a private island or beach property, assemble a verified brief: what you can own, what you can build, how you will get there, and how the place will run. That brief gives the architect meaningful constraints and gives the buyer a way to compare properties beyond the listing photographs.
Resolve the expensive dependencies first. A villa layout can change; uncertain access, unsuitable ground, or an unapproved wastewater proposal may change the entire project. Keep those questions visible until the responsible adviser has provided an answer you can use.
Proceed to detailed design when the legal review, technical investigations, preliminary budget, and operating plan support the same proposal. If they do not, adjust the scope or reconsider the site before committing more resources.

FAQ
What is private island design?
Private island design is the planning of architecture, landscape, utilities, access, and environmental protection as one system. It is not just villa styling. A good plan decides where to build, what to leave untouched, how solar and water systems work, how guests arrive, and how the reef or shoreline stays protected.
What should a private island design brief include?
Include intended use, occupancy, buildable areas, setbacks, protected habitat, arrival and service routes, water demand, power, wastewater, staff spaces, and maintenance access. Add a preliminary budget, phasing plan, permissions schedule, and the evidence behind each assumption. The brief should distinguish confirmed conditions from items still awaiting surveys, quotations, or advice.
How much does it cost to develop a private island?
There is no reliable universal development price for a private island. Obtain estimates for surveys, professional services, approvals, transport, marine works, buildings, utilities, and ongoing operations. Specify what each quote includes and excludes, and test the cost of unresolved requirements. A listing price or another island’s construction budget is not a substitute for site-specific estimates.
What legal factors should I consider when buying a private island?
Have an independent local lawyer verify title or lease terms, buyer eligibility, boundaries, easements, public beach access, permitted uses, and the approvals needed for buildings and marine works. Confirm transfer conditions and any restrictions on existing approvals. The phrase private island or private beach does not establish exclusive shoreline rights or permission to develop.
How can I assess the potential financial return on an island investment?
Build a cash-flow model using documented capital costs, financing terms, operating expenses, and evidence for any expected rental income. Test lower occupancy, access interruptions, delayed approvals, major repairs, and a slower resale. Have qualified financial and tax advisers review the assumptions. Good architecture does not establish a particular yield or guarantee capital appreciation.
What environmental and sustainability practices should I implement on my island property?
Start with a site-specific environmental assessment. Use its findings to plan habitat protection, construction access, runoff control, water supply, wastewater treatment, and waste removal. Have engineers assess energy demand and equipment safety. Assign maintenance and monitoring responsibilities before occupation, and verify the relevant permissions rather than treating a generic sustainability checklist as approval.
What are the key considerations for financing and conducting due diligence on an island purchase?
Confirm financing availability and conditions with the lender for the specific property and buyer. Coordinate the legal review with surveys, environmental assessment, access checks, a cost plan, and an operating budget. Ask advisers which outstanding matters should be addressed in the purchase contract, and keep informal financing indications separate from binding commitments.
